Transformer makers are usually compared on price and lead time alone. Five product lines cover the range we build. Each one carries its own rating schedule, its own construction rules and its own specification path.
Engineers who compare electric transformer manufacturers rank them by who they have already used, not by who claims the most — and an unfamiliar name has nothing in that column.
Procurement teams say the same thing in their own words: it is a long process to qualify new vendors, and a longer one to qualify and approve new products. One utility supplier programme puts a full quality-assurance review at up to six months before a name reaches the approved list.[9]
Unlike a price sheet, a qualification file cannot be improvised at tender stage — which is the trade-off a new supplier has to solve before anything else.
So the useful question is not whether a supplier says yes. It is whether the evidence to qualify them is already on the table… Every line below is published with its rating schedule attached, which is the part a qualification file actually needs.
S11 and SF11 oil-immersed series at 35 kV class
High voltage transformer manufacturers are compared on the 110–220 kV schedule, and ours publishes loss, impedance, shipping envelope and mass on every row
High-capacity substation duty sized against grid duty, fault level and insulation coordination
Single-phase and three-phase compartmental designs
Radial or loop feed, dead-front or live-front bushings
Impedance band of 2.8% to 5.75% depending on rating
Single-phase pole-mounted from 5 to 167 kVA
Conventional, completely self-protected and breaker-protected variants
Sealed three-phase distribution units to the S13-M schedule
Fully sealed S13-M distribution schedule from 30 kVA
Amorphous-alloy variants where no-load loss dominates the duty
Cold-rolled grain-oriented silicon steel cores throughout
Cast-resin SC(B) series with loss stated at three thermal classes
Open-wound SG(B) series with published sound level in decibels
Indoor, occupied and fire-sensitive installations
A product family name tells a buyer almost nothing. What decides whether a supplier can serve a project is the rating schedule behind that name, and whether the loss column in it is filled in. Each schedule below states its loss values under the general requirements of IEEE C57.12.00, which is also where the tolerance on those values comes from.
A transformer runs for thirty years or more. Over that time the energy it wastes usually costs more than the machine did.
Both come from your electricity cost, your discount rate and your evaluation life — not from us.
If you do not yet have your own factors, USDA Rural Utilities Service bulletin 1724D-107 sets out how they are derived and works a full example. Use your own figures on this page rather than ours; the two below are round numbers chosen to show the arithmetic.
The United Nations Environment Programme’s United for Efficiency guide puts the cost of those losses at up to four times the purchase price of the machine.[3]
Contrary to how most bids are scored, the lowest purchase price rarely produces the lowest cost of ownership.
In the United Nations Environment Programme’s worked comparison, the unit that cost 539 euro more to buy came out 1,510 euro cheaper across its life.[3]
Surprisingly little of the total is the invoice: purchase price accounts for a minority of what the asset costs over a 25 to 35 year service life, while loss cost can reach four times the purchase price.[3]
In fact the harder problem is not choosing between two loss figures. It is that most transformer manufacturers publish none, so the calculation cannot be started.
We checked: across the three manufacturer homepages ranking in the organic top five for this category, the number of published loss values is zero, and not one of their 31 stated figures carries a source.
A quotation only becomes comparable when the electrical duty, the loss values and the commercial scope all describe the same machine. Publishing the loss column is how that comparison starts.
Take the 50 kVA single-phase pad-mounted unit from our schedule. Its published no-load loss is 135 W and its published load loss is 500 W.
| Input | Value | Where it comes from |
|---|---|---|
| No-load loss | 135 W | Our published schedule |
| Load loss | 500 W | Our published schedule |
| A factor | $5.00 / W | Illustrative only. This is your number, derived from your electricity cost, discount rate and evaluation life |
| B factor | $1.50 / W | Illustrative only. Same — it follows your loading profile |
| Capitalised loss value | $1,425 | 135 × 5.00 + 500 × 1.50 |
Run the same arithmetic on a competing offer and the comparison becomes real. You cannot run it at all on a page that does not publish a loss figure.
Design values are what our schedules publish, and they state what a family is engineered to achieve at a given rating.
What binds is the measured value. Every unit ships with a certified factory test report carrying the measured no-load and load loss for that serial number.
Under IEEE C57.12.00 the measured no-load loss may not exceed the quoted value by more than 10%, and total loss by more than 6%, verified by the routine tests in IEEE C57.12.90.[1][2]
Put the numbers in the contract. If your specification carries loss evaluation factors or a penalty formula, send them with the enquiry and we will quote against them.
Calculate exactly what your transformer will cost over its lifetime.
Every figure in this schedule is produced by the routine tests defined in IEEE C57.12.90. Below is one schedule in full, so you can see the level of detail every enquiry is answered at. Our 110–220 kV oil-immersed range carries loss, impedance, envelope and mass on the same row.
| Rated capacity | No-load loss | Load loss | No-load current | Shipping envelope L×W×H | Total mass |
|---|---|---|---|---|---|
| 6,300 kVA | 10 kW | 36.9 kW | 0.6% | 4,540 × 4,350 × 4,580 mm | 21,100 kg |
| 10,000 kVA | 14.2 kW | 53.1 kW | 0.5% | 4,900 × 4,450 × 4,830 mm | 27,900 kg |
| 16,000 kVA | 20 kW | 77 kW | 0.45% | 5,620 × 4,520 × 5,080 mm | 35,600 kg |
| 25,000 kVA | 28.4 kW | 110.7 kW | 0.4% | 5,820 × 4,590 × 5,290 mm | 45,200 kg |
| 31,500 kVA | 33.5 kW | 133.2 kW | 0.35% | 5,930 × 4,820 × 5,400 mm | 49,600 kg |
| 40,000 kVA | 40.4 kW | 156.6 kW | 0.3% | 6,100 × 4,930 × 5,500 mm | 57,100 kg |
| 50,000 kVA | 47 kW | 194.4 kW | 0.25% | 6,450 × 5,050 × 5,590 mm | 64,700 kg |
| 63,000 kVA | 56.8 kW | 234 kW | 0.25% | 6,970 × 5,190 × 5,690 mm | 71,800 kg |
Short-circuit impedance on this schedule is 10.5%. Mass and envelope are the figures your rigging contractor and route survey need, and they are on the page rather than behind a form.
A 71,800 kg unit on a 6,970 mm frame is a route survey and, on many corridors, an oversize permit — both of which have to start before the order, not after the vessel sails.
Unlike suppliers who withhold mass and envelope until quotation, we publish them here, because holding them back does nothing for the buyer and quietly pushes the scheduling risk downstream.
The tell is simple: if a substation transformer manufacturer cannot give you a shipping envelope before the order, the route survey has not been thought about yet.
The no-load current column matters too: it falls from 0.6% at 6,300 kVA to 0.25% at 63,000 kVA, which changes how the unit behaves energised but unloaded.
Send your kVA, voltages, frequency, vector group and impedance target. We will come back with the schedule row that fits and the ones that do not.
Our transformers are made in China, at our own plant in the Hai’an Economic and Technological Development Zone in Nantong, Jiangsu. Transformers made in China now carry a large share of world supply, and a buyer deserves that stated plainly rather than left to be worked out from an address.
Roughly one fifth of large transformer orders in the United States are filled by domestic suppliers, so buying an imported unit is the ordinary case rather than an exception.[10]
Average transformer lead times ran 115 to 130 weeks in recent tracking, against a pre-pandemic norm of 30 to 60 weeks, while prices rose 60% to 80% from January 2020.[7]
One US utility reported single-phase pad-mounted lead times moving from 16 weeks to 142 weeks over the same period.[8]
Against that backdrop the useful question is not domestic or imported. It is which supplier hands you enough evidence to qualify them.
| Decision area | What changes | What does not |
|---|---|---|
| Schedule | Ocean transit and customs clearance sit between the factory gate and your site | The factory window itself is published above, by capacity band |
| Evidence | You cannot walk the floor on a Tuesday afternoon | The certified test report with your serial number’s measured losses ships with the unit either way |
| Compliance | Import classification, duty and any market-approval requirement land on your side | Design and test conformity is stated the same way it would be from any manufacturer |
| Recourse | Governing law and the claim route are contract items to settle before the order | The loss tolerance yardstick is a published standard, not a negotiation |
Run all three answers through the total owning cost arithmetic above. A China transformer manufacturer who cannot fill the loss column is no more comparable than a domestic one who cannot, which is the point: the test is the evidence, not the address.
Anyone searching for transformer manufacturers in China will find no shortage of ranking lists. What is harder to find is a manufacturer publishing the numbers those lists never contain.
An unfamiliar supplier is a paperwork problem before it is an engineering problem. We deal with that by making the evidence package part of the product.
The problem buyers hit is not that a supplier refuses to answer. It is that the answer arrives as an adjective, and an adjective cannot be filed against a specification.
The reason is structural: a transformer is accepted on measured values, not on described ones, and the measurement happens once, in a factory the buyer is not standing in.
Toplit resolves that by shipping the measurement with the machine — the routine tests in IEEE C57.12.90 produce the numbers, and the certified report carries them under the serial number.
Those numbers are checkable against IEEE C57.12.00, which caps measured no-load loss at 10% and total loss at 6% above the quoted value, on units rated from 15 kVA to 63,000 kVA and from 2.4 kV to 220 kV.
Units are designed and factory-tested against IEEE, IEC and ANSI design and test references, with the governing standard and edition fixed in the quotation.
A design standard is not a market approval — designing and testing to IEEE or IEC says nothing about whether a given jurisdiction will accept the equipment.
Workplace equipment carries its own rule — OSHA requires electrical equipment used in US workplaces to be approved by a Nationally Recognized Testing Laboratory under 29 CFR 1910.303(a), using US-recognised test standards.[5] Utility-owned assets sit under a different regime.
For covered equipment, the importer carries the file. Where a US Department of Energy conservation standard applies, the importer is treated as the manufacturer and owns the compliance evidence. That is precisely why the test report and material certificates matter to you and not just to us.
Tell us the acceptance requirement in the enquiry — which authority, which scheme, which mark — and we will state in the quotation what we can and cannot supply against it.
Each factor is directly tied to the technical specifications and operational requirements established by your engineering team.
Core steel grade and conductor metal move with the loss target you set.
Insulation coordination, clearances and terminal arrangement scale with the BIL.
Lower loss means more material, a larger core window and more mass.
Witnessed tests, special tests and approval cycles are engineering work.
Quantity, mass, lifting points, packing and destination are priced together.
Distribution-class units up to 2,500 kVA ship in 20 to 45 days ex-works once drawings are approved. Power-class units from 110 kV are scheduled per project and confirmed in the quotation.
30% deposit by T/T with the 70% balance before shipment, or an irrevocable L/C at sight.
EXW, FOB, CFR and CIF. Other arrangements are agreed in the contract.
12 months from commissioning as our published minimum, with longer terms agreed in the contract.
Ex-works terms put the international leg in your hands, which most experienced buyers prefer. It also means a few things belong on your side of the schedule from day one.
Wood Mackenzie put average transformer lead times at 115 to 130 weeks in 2024, against a pre-pandemic norm of 30 to 60 weeks, with prices up 60% to 80% since January 2020.[7] One US utility reported single-phase pad-mounted lead times moving from 16 weeks to 142 weeks.[8]
Budget the sailing and port time on top of the factory window when you build the project programme.
Roughly one fifth of large transformer orders in the US are domestic, making imported units standard.[10]
Confirm the heading and the current duty rate with your customs broker before the purchase order.
A 40-tonne unit needs a route survey and, on many corridors, an oversize permit.
Commercial invoice, packing list, bill of lading and certificate of origin travel with every shipment.
Our units go into urban and rural distribution networks, petrochemical plants, metallurgy, light textile industry, mining, ports and residential developments.
Picture a data center feeder that stays energised around the clock. The risk is not capacity, it is that no-load loss runs 8,760 hours a year, so a unit at 0.25% no-load current buys you a materially lower operating cost than one at 0.6% — and that gap only becomes visible if the supplier publishes both figures.
Take a petrochemical plant with large motor starting instead. Here the problem is mechanical: repeated inrush stresses the windings, and the trade-off is impedance, because raising it limits fault current while costing voltage regulation. Toplit engineers that choice against the fault study rather than against the nameplate.
A transparent look inside our production workflow. From raw material handling to final high-voltage testing, our facility is engineered for precision, compliance, and industrial-scale output.
Enter the duty and this returns which of the eight Toplit rating schedules covers it, what that schedule publishes, and which product page to read next. It routes an enquiry; it does not select a transformer.
Published dimensions and mass for the 110–220 kV oil-immersed schedule, checked against the transport limits you are working to. Use it to start the route survey before the order, not after the vessel sails.
Builds the whole programme, not just the factory window: drawing approval, build, ocean transit and inland movement. It is a planning estimate for your schedule, and the binding dates come from the quotation.
Rated kVA, primary and secondary voltage, frequency, phase, vector group, target impedance and the load profile, plus the installation environment. Send the single-line diagram and load schedule if you have them, and mark the fields you do not know rather than filling them with assumptions.
Distribution-class units up to 2,500 kVA ship in 20 to 45 days ex-works once drawings are approved. Power-class units from 110 kV are scheduled per project and the window is confirmed in the quotation.
Yes. Every schedule we build to carries its design no-load and load loss, and one full schedule is on this page.
Normalise the technical scope first — conductor material, losses, temperature rise, impedance, enclosure and accessories. Two power transformer manufacturers quoting the same kVA can be describing different machines.
Then add the capitalised loss value using your own A and B factors.
Then check the test and document scope, because that is where quoted prices most often diverge. Electrical transformer suppliers who bundle testing differently will look cheaper without being cheaper.
30% deposit by T/T with the 70% balance before shipment, or an irrevocable L/C at sight. Delivery is on EXW, FOB, CFR or CIF terms, with other arrangements agreed in the contract.
Yes. Units are designed and factory-tested against IEEE, IEC and ANSI design and test references, and the governing standard and edition are fixed in the quotation. Tell us which framework the project runs on at the enquiry stage, because it changes the test plan as well as the design.
IEEE C57.12.00 sets the ceiling: measured no-load loss may not exceed the quoted value by more than 10%, and total loss by more than 6%. Those limits are checked by the routine tests in IEEE C57.12.90, and the result for your serial number is what appears on the certified test report.
Many utility specifications go further and attach a penalty formula, expressed in dollars per kilowatt of excess no-load or load loss.
That formula shifts the cost of a design missing its target onto the supplier rather than onto the network.
Send it with the enquiry, together with your A and B loss evaluation factors, and we will quote against them rather than around them.
Not automatically. A design standard, a federal efficiency rule and a workplace product approval are three separate questions, and each has to be settled for the exact model and the exact installation. Tell us which acceptance route applies and we will state in writing what we can supply against it.
Insulation and cooling medium differ, which changes the fire strategy and the containment requirement.
Dry-type suits occupied, indoor and fire-sensitive rooms; oil-immersed generally offers higher power density.
Capacity, environment, ventilation and local rules decide it — not a general preference.
Yes, from 15 to 167 kVA with high-voltage combinations up to 34,500/19,920 V. The schedule publishes no-load loss, load loss, dimensions, oil mass and total mass for each rating.

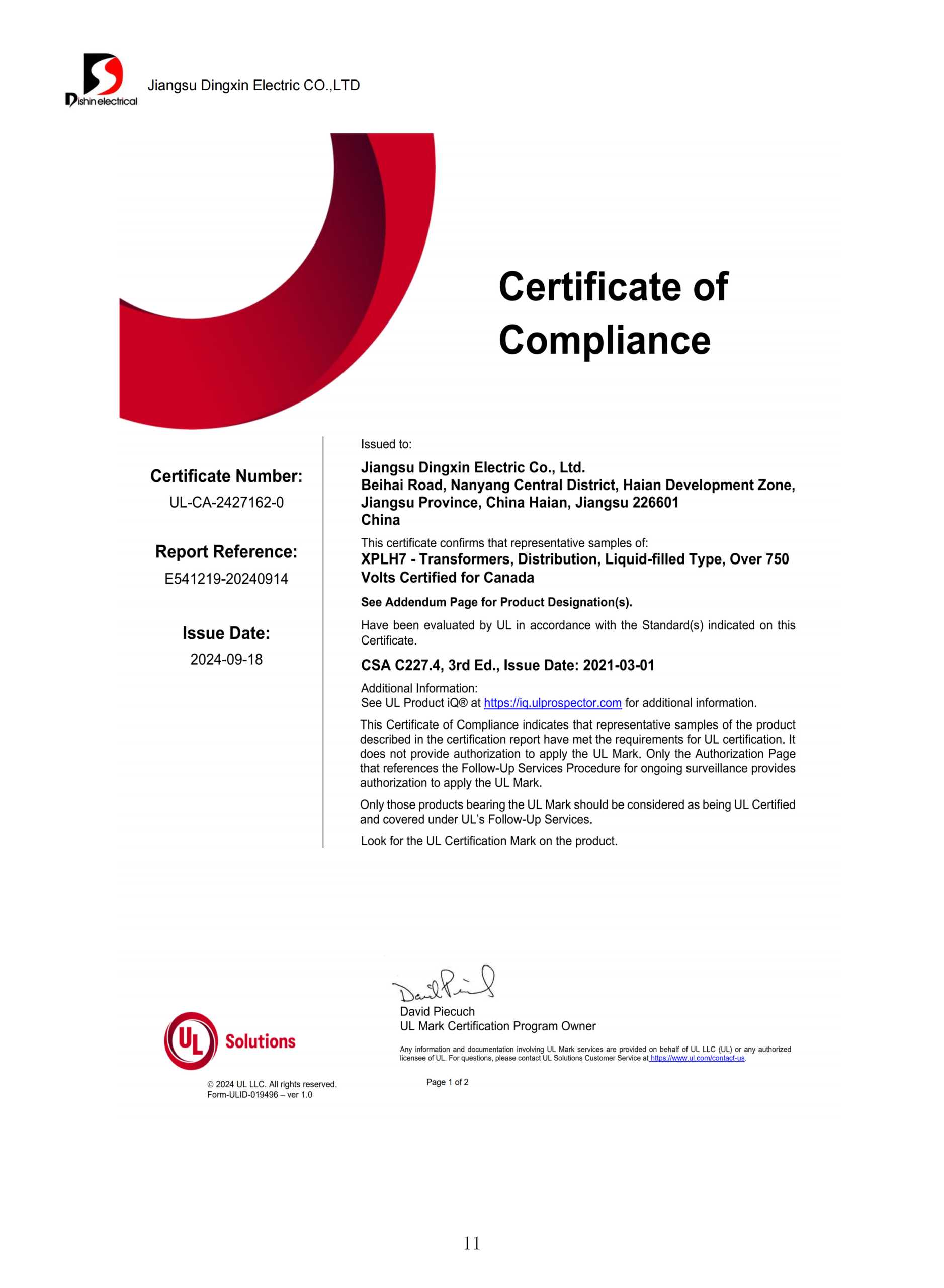

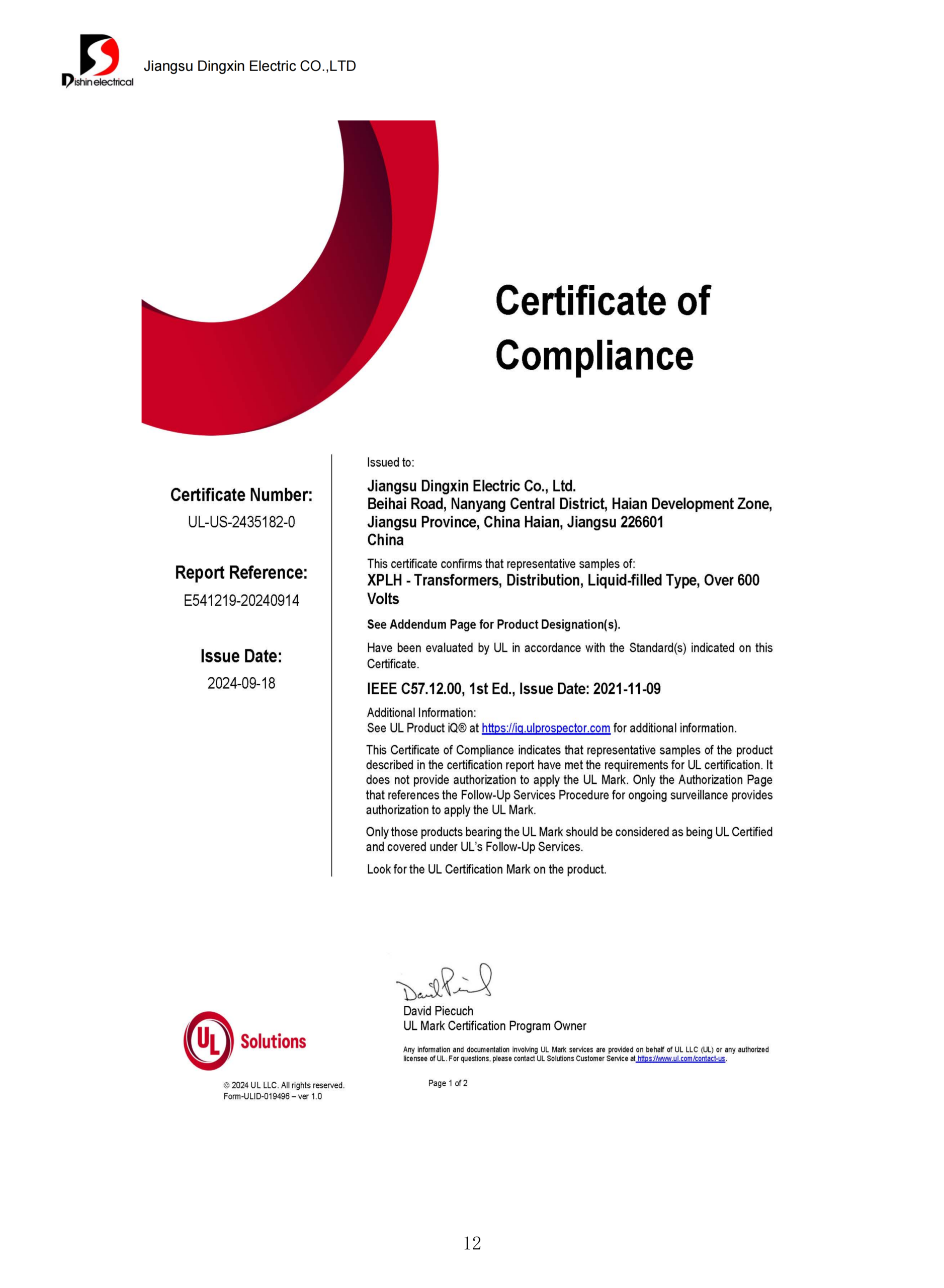

A certified factory test report with the measured losses for that serial number, material certificates for core steel, winding conductor and dielectric fluid, as-built outline and terminal drawings, and the rated data sheet. If your acceptance procedure needs anything beyond that list, name it in the enquiry so it is priced rather than negotiated after delivery.
Yes. Witnessed testing is written into the test plan at the quotation stage, so scope and acceptance criteria are agreed before anything is built.
